The Sound Transit Board System Expansion Committee this week received a detailed briefing on continuing efforts to identify new opening dates for current Link construction projects, as Sound Transit works with contractors to address construction challenges.
Here’s more from Sound Transit:
Since April of this year, Sound Transit has been flagging delays affecting East Link, Lynnwood, Federal Way and Downtown Redmond Link extensions, including current issues and trends that are global in nature and others that are local and project specific.
While continuing work is required to identify new project opening timelines, based on the most recent assessments, completion of construction for the Lynnwood and Redmond projects, previously scheduled for mid-2024, may be impacted by four to six months, only slightly exceeding the more than four-month delay caused by the concrete delivery strike that ended in April.
The Federal Way Link Extension faces an unexpected ground instability issue that has the potential to require redesigning a segment in Kent adjacent to I-5 and South 259th Place. While it is too early to accurately assess the resulting construction delay, we now expect the project completion to extend some number of months into 2025 rather than occurring in late 2024.
On East Link, ongoing work to address construction challenges is projected to delay the project by at least a year beyond the previously scheduled mid-2023 opening.
Identifying new opening timelines requires continuing work to resolve project risks, as well as a programmatic review that is getting underway.
“Within about the next four years, our carbon- and congestion-free light rail system will more than double from 26 to 62 miles and from 25 to 50 stations,” said Sound Transit Interim CEO Brooke Belman. “While we are on a path to fully resolve impacts of COVID-19, the concrete delivery strike and our construction challenges, we have more work to do before we can reliably establish opening dates. We will work tirelessly with our contractors to complete these extensions as rapidly as possible without compromising on safety or quality.”
Today’s System Expansion Committee update summarized construction challenges in detail. On East Link, the biggest challenges involve construction quality and durability concerns about plinths, or raised concrete structures, that support the tracks in key sections of the alignment.
On both the east and west sides of the I-90 floating bridge, the contractor’s work to fix problems with cast-in-place concrete plinths supporting the tracks has led to the identification of further challenges. These include issues with mortar pads, rebar placements and track fasteners, which the contractor has agreed to fix by re-casting the plinths to ensure the long-term reliability and safety of the extension.
The agency has also been closely analyzing concerns related to pre-cast concrete blocks supporting the tracks on the bridge itself. Fortunately, a forensic engineering firm’s preliminary investigation results during July and August indicate the blocks do not need to be replaced.

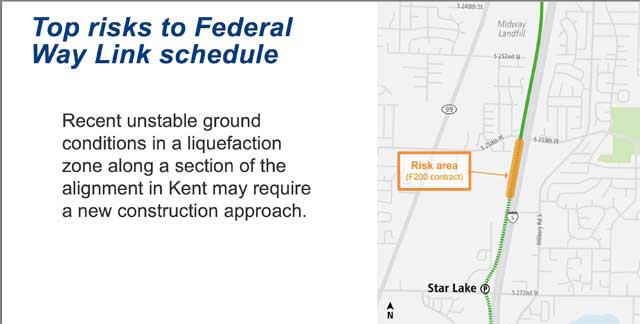

On the Federal Way Link Extension, the previously mentioned ground stability issue involves a slope adjacent to I-5 that recently experienced a localized failure. On July 19, approximately 200 linear feet of embankment slid downslope by approximately nine feet, requiring a roughly three-day precautionary lane closure on southbound I-5. The slope has been temporarily stabilized, and Sound Transit and its design-build contractor are working with the Washington State Department of Transportation on permanent design solutions that will address a liquifiable layer of soil that has been identified fairly deep below the light rail alignment. Work to identify solutions will remain focused on minimizing delay to the project.
Work is moving forward in two areas to support updating opening timeframes for the projects:
- Implementing action plans to resolve project risks and challenges: Specific action plans are underway to address quality challenges. Additionally, staff have implemented changes supporting intensified inspections and monitoring of contractors’ work. Work continues to assess required timelines for implementing fixes.
- Conducting a programmatic risk assessment: Work is also getting underway to analyze the implications of the projects collectively. Since each project is part of a system, we need to look at the projects’ current status at a programmatic level, with focus on details of project sequencing. The programmatic analysis is critical because staffing and safety considerations mean that light rail segments that are in construction must be activated sequentially within appropriate safety and staffing parameters, with up to six months of testing prior to activating each segment.
Sound Transit will maintain intensive focus on these tasks and opening the projects as rapidly as possible without compromising their safety and quality. Action plans responding to project challenges are summarized in a presentation provided at this week’s meeting and a detailed memo.
Sound Transit builds and operates regional transit services for growing urban areas of Washington’s Pierce, King and Snohomish counties. The region is home to more than 50 cities and more than 40 percent of the state’s residents, who have authorized the most ambitious transit expansions in the nation. In the coming years Sound Transit’s Link light rail system will grow from 26 to 62 miles, before reaching 116 miles following the completion of further voter-approved projects. The system is the first nationally to operate entirely on carbon-free electricity.
Sound Transit is also preparing to add Stride bus rapid transit service to its mix of services, alongside Sounder rail service that will continue expanding and a broad network of ST Express regional bus routes. Sound Transit’s trains and buses integrate seamlessly with the services of other local transit agencies.
